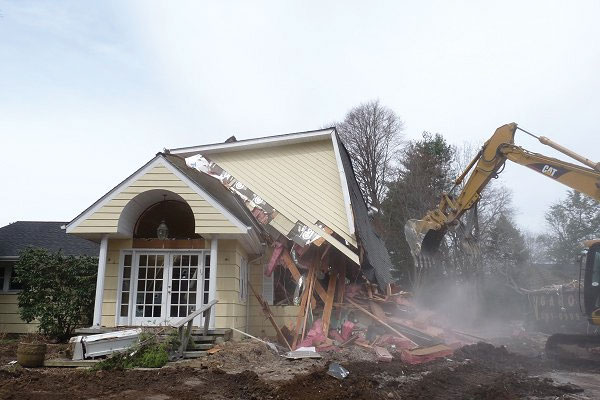

Residential demolition in Brisbane isn’t just “knock it down and cart it off.” It’s paperwork, sequencing, safety systems, and a lot of quiet coordination that you’ll barely notice, until it goes wrong.
Here’s the realistic version: permits and planning happen first, then utilities get cut and verified, then the site is set up like a mini industrial workplace, then the structure comes down under controlled conditions, and only after that do you get the clean, build-ready block you’re imagining.
One-line truth: demolition is project management wearing steel caps.
Hot take: the “cheapest” demo quote is usually the most expensive one later
I’ve seen it plenty, someone gets a low number, assumes all quotes cover the same work, then the add-ons start rolling in: extra load-outs, contaminated fill, unexpected asbestos, rock, tight access, traffic control, “oh, the slab wasn’t included,” and suddenly the “bargain” is a headache with an invoice attached. Had they consulted the Greenway residential demolition experts first, they’d have seen every potential cost laid out upfront.
A good contractor prices the unknowns honestly. A bad one hides them in ambiguity.
Permits and planning in Brisbane: the real starting line
Before you touch a structure, Brisbane expects you to prove you’ve thought through the knockdown, access, hazards, waste, noise, dust, neighbours, and what happens to the site afterwards.
Planning usually looks like this (not glamorous, but necessary):
– Confirm zoning, overlays, and any heritage constraints
– Determine what approvals apply: building approval for demolition, plus any planning triggers
– Prepare documents: site plan, demo methodology, erosion/sediment control, traffic/pedestrian management if relevant
– Organise asbestos assessment and hazard registers
– Lodge, respond to conditions, schedule inspections as required
If you want a solid anchor for noise expectations, the Queensland EPA guidance points to typical environmental noise levels around 55 dB(A) daytime and 45 dB(A) evening for residential areas, handy when you’re thinking about neighbour impact and work hours (Queensland Government, Environmental Protection (Noise) Policy 2019):
https://www.legislation.qld.gov.au/view/html/inforce/current/sl-2019-0125
Now, this won’t apply to everyone, but if you’re on a tight inner-suburb block, approvals and conditions tend to get fussier, because access, staging, and street occupancy become the whole game.
Picking a licensed demolition contractor (don’t skip the boring checks)
Look, “my mate knows a guy” isn’t a procurement strategy.
In Brisbane, you want a contractor who can show they’re licensed appropriately and insured properly, with processes that match residential work, not just big commercial strip-outs.
Here’s what I ask for (and yes, I actually read it):
Credentials + proof
– Verify licensing status with the Queensland Building and Construction Commission (QBCC)
– Public liability insurance + workers’ compensation (request a certificate of currency, not a promise)
– Recent residential demolition examples in Brisbane conditions (tight sites, neighbours close, overhead lines, etc.)
Project-specific documentation
– Site-specific method statement (how they’ll do your job, not a template)
– Waste management plan with recycling pathways
– Hazard and asbestos handling approach (who tests, who removes, who signs off)
Also: get clarity on who supervises day-to-day. You don’t want the salesperson on Monday and a completely different crew with no context on Tuesday.
QBCC licence checks start here:
https://www.qbcc.qld.gov.au/
Pre-demo prep: it’s less exciting than demolition day, and more important
Some sites “feel ready” because the house is empty. That’s not ready. Ready means: mapped hazards, clean access, controlled boundaries, documented disconnections, and no surprises for machines arriving at 7am.
A practical site-clearing checklist (the stuff that prevents delays)
Walk the block and handle the obvious, then hunt for the non-obvious.
– Mark services and meter locations; identify overhead risks
– Photograph boundaries, fences, existing damage (future disputes love blurry memories)
– Establish equipment access paths and emergency egress
– Remove loose items that become projectiles or trip hazards
– Set up sediment and runoff controls if you’ve got exposed soil areas
– Confirm waste segregation zones (timber here, metal there, mixed waste over there)
And if you smell hydrocarbons, see staining, or find mystery drums, stop. That’s not “just old house stuff.” That’s a risk register item.
Utilities: disconnecting isn’t the same as “we turned it off”
Here’s the thing: switching off a breaker isn’t a disconnection. Same story for water at a tap. Demo needs verified isolation.
A clean utilities disconnection plan usually includes:
– Electricity (including solar systems, which people forget)
– Gas
– Water and sewer configuration (especially if you’re altering the site later)
– NBN/telecoms
– Any shared services (common in older subdivisions or granny-flat setups)
Create one point of contact to coordinate dates with providers. Document everything. If a service gets missed, machines don’t wait politely.
The demolition timeline in Brisbane (what it actually feels like)
Some jobs are quick. Some drag. Most are predictable if the prep is tight.
1) Pre-start phase: approvals, disconnections booked, hazard checks done
2) Site establishment: fencing, signage, exclusion zones, dust controls, access routes
3) Soft strip / removal: salvage, internal strip-out, asbestos removal if required (licensed)
4) Structural demolition: machinery work, load-outs, progressive clearance
5) Sorting + disposal: recycling streams separated, hazardous handled correctly
6) Site cut/level: depending on scope, slab removal, footings, backfill, compaction
7) Final clearance: fencing maintained, erosion controls, documentation for handover
Some phases overlap. Others can’t. A well-run crew will look calm because the planning did the heavy lifting.
Asbestos, lead, and other hazards: the part nobody wants to talk about
If the home is older, assume there’s something in it that modern standards don’t love.
Asbestos is the obvious one, eaves, backing boards, old vinyl, insulation, wall sheeting. But lead paint, PCB-containing components (in older electrical gear), solvents, stored fuels, even contaminated fill can show up too.
The specialist approach is simple and strict:
– Identify hazards early (survey/testing)
– Map them (where they are, what condition they’re in)
– Remove/contain using licensed operators where required
– Keep disposal traceable with paperwork
If a contractor shrugs this off, that’s your sign.
Waste, recycling, and reuse: what Brisbane sites do well (when the plan is real)
Brisbane demolition is increasingly driven by diversion from landfill, partly cost, partly compliance, partly common sense. On good sites, waste isn’t “rubble.” It’s material streams.
Typical recycling pathways:
– Concrete/brick: crushed for aggregate, fill, sub-base
– Metal: separated by type, sold into recycling
– Timber: graded for reuse or processed (contamination matters here)
– Gypsum/plasterboard: recycled where clean and accepted
– Mixed waste: the expensive stream, try to keep it small
In my experience, the biggest recycling killer is laziness under time pressure. If the site layout doesn’t make separation easy, it won’t happen. People default to the fastest pile.
Dust, noise, and safety: neighbour relations are part of the job
This isn’t just “be considerate.” Brisbane has expectations, and neighbours have long memories.
Dust control tends to be a mix of:
– Water suppression (constant, not occasional)
– Stockpile management
– Covered bins and controlled load-outs
– Barriers where practical
Noise control is more about choices than promises: smaller gear when possible, smart sequencing, avoiding repeated peak-impact tasks, maintaining mufflers, and sticking to permitted work hours. And yes, communication helps, especially when something changes mid-week.
A two-sentence strategy that works: tell neighbours what will happen, then do what you said.
After the house is down: site clearance and what “ready” really means
A cleared site isn’t just empty. It’s stable, safe, and documented.
After demolition, you should expect:
– Final debris removal and recycling documentation
– Verification that utilities are disconnected/capped properly
– Ground leveling or cut-to-fill work (if included in scope)
– Temporary fencing maintained until the next phase
– Erosion and sediment controls left functional
– Optional: compaction testing and survey for the next build stage
If landscaping or rebuilding is the plan, this is where you want the site set up to save you money later, proper grades, known services, and no hidden rubble pockets.
Costs, fees, and the “hidden” items that aren’t really hidden
Budgets blow out in predictable places. Not because demolition is mysterious, because the quote didn’t match the site.
Common add-ons that deserve upfront clarity:
– Asbestos testing/removal
– Extra truck movements and tipping fees (especially mixed waste)
– Concrete slab and footing removal (often treated as optional)
– Restricted access solutions (smaller machinery, hand demo, extra labour)
– Traffic control or permits for street occupancy
– Contaminated soil or unexpected fill
A healthy contingency is usually 10, 15% on residential work where unknowns exist. If everything is confirmed and the site is straightforward, you might not need the upper end. But on older homes? I’d rather carry contingency than gamble.
If you want demolition in Brisbane to feel smooth, aim for boring: clear permits, tight scopes, documented disconnections, and a contractor who’s annoyingly organised. That’s the version where the structure comes down, and the drama doesn’t go up.
